Basement egress window installation with masonry well in Arlington, VA

Egress Window Installation in Arlington, Alexandria & Fairfax

Structural Excavation. Legal Bedrooms. Master Masonry.

Request an Estimate
Class A Licensed GC
Owner-Operated
5-Star Rated
No Salesmen

Add a Legal Bedroom

A basement room does not legally count as a bedroom in Virginia unless it has a code-compliant egress opening — a window or door large enough for an occupant to escape a fire and for a firefighter in full gear to enter. Cutting that opening is what converts unfinished square footage into a legal, appraisable bedroom, which is why an egress window is one of the highest-return structural improvements you can make to a home in Arlington, Alexandria, or Fairfax.

It is also a genuinely structural project. The egress opening has to be cut through the load-bearing concrete foundation that carries the floors and roof above it, so the work is governed by a building permit, a structural header, and a county inspection — not a weekend kit. Because the cut is load-bearing, we coordinate a licensed Virginia Professional Engineer (PE) to produce the stamped header design and build the opening to that stamped drawing. We do not install pre-fabricated plastic window wells that bow and crack under soil pressure. Every Tuck egress is built the way a foundation is: a steel-reinforced concrete footing, a structural CMU well, active drainage, and a stone-veneer or brick finish.

1. The Diagnostic: The Failure of Plastic Kits

Many contractors sell "quick" egress installations using a corrugated steel or pre-formed plastic window well dropped into the hole. The failure mode is predictable. Northern Virginia's marine clay is an expansive soil — it swells when it absorbs water and exerts steady lateral pressure on anything buried in it. When you excavate a six-foot hole against a foundation in Fairfax or Burke, that saturated clay pushes back with thousands of pounds of force. A thin plastic shell has no way to resist it: over a few freeze-thaw seasons the well warps, cracks, and bows inward against the window, defeating the very escape path it was supposed to create.

The second failure mode is water. A plastic kit is typically set over a shallow gravel pit on the assumption that rainwater will percolate away. In clay, it does not — the pit has nowhere to drain. During a heavy Virginia downpour the well fills like a bucket, water rises above the sill, breaks the window seal, and floods the finished basement. A well that holds water also loads the glass hydrostatically, which is how egress windows get cracked from the outside. Building it correctly means a structural retaining wall around the well and a drainage system that actively evacuates water, not a pit that hopes it disappears.

2. The Tuck Standard Protocol: Structural Egress Construction

We approach an egress project with the same rigor as building a new foundation, whether the scope is a single window cut or a multi-tiered structural walkout stairwell. The walkout is the larger undertaking — far more excavation, a taller retaining system, and an exterior staircase — but the protocol does not change:

  • Structural Demolition & Header Integration Before any concrete is cut, we temporarily shore the floor joists inside the home so the structure is supported while the wall is open. Using hydraulic diamond wall saws, we cut a clean, square opening through the 10-inch poured-concrete or block foundation wall. A steel or LVL header — sized by the licensed PE to carry the load above — is then set across the top of the opening so the weight that was bearing on that section of wall transfers around the new void to the sides of the cut.
  • The Masonry Well (Concrete Footer & CMU) Instead of plastic, we build the well as a structural retaining wall. We pour a steel-reinforced concrete footing at the base of the excavation, then lay up the well walls in Concrete Masonry Units (CMU block) with the cores reinforced by vertical rebar and solid grout. The result is a rigid, soil-resisting wall that holds the marine clay back and will not bow against the window the way a kit does.
  • Active Drainage We do not rely on a passive gravel pit. A rigid drain line is set at the base of the concrete footing to capture water at the lowest point of the well. Depending on the grade of your property in Great Falls or Clifton, that line either runs downhill to daylight, ties into the home's interior foundation drain tile, or feeds a dedicated exterior sump pump that mechanically ejects water away from the well. On clay sites, where water cannot percolate, this is the difference between a dry basement and a flooded one.

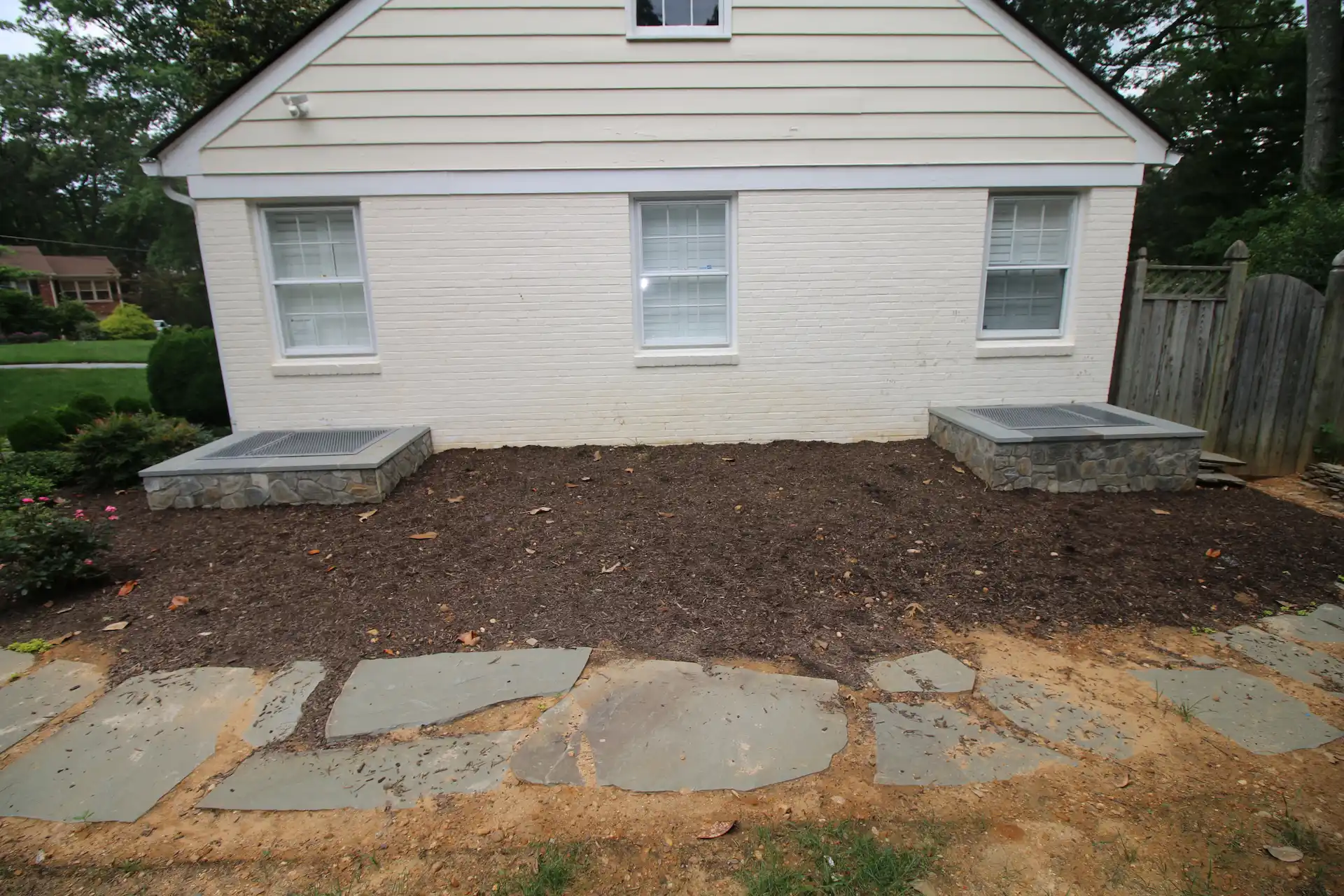

  • Finishing (Stone Veneer & Custom Covers) A well built this way can be finished to look like part of the house rather than a utility pit. Our masons face the inside of the CMU with natural stone veneer or brick to match the foundation, and build code-compliant masonry steps into the well instead of a bolt-on metal ladder. The well is capped with a custom iron safety grate or a polycarbonate cover rated to bear weight while still passing daylight into the basement — and the cover must not impede egress from the inside.
  • The Window / Door Installation We finish the opening with an energy-efficient casement or inswing window (such as Andersen or Marvin) sized to meet the egress clear-opening requirement, not just to fill the hole. For a full walkout, we hang an exterior-grade French or entry door (such as ProVia) integrated with PVC trim and a watertight sill pan so the new opening sheds water rather than channeling it inside.

3. Material Science: Egress Methods Compared

Construction Method Structural Integrity Drainage Reliability Aesthetic Impact
CMU Block + Stone Veneer (Tuck Standard) High. Rebar-and-grout core resists lateral soil pressure. Active line to daylight or sump pump; drains under load. Stone or brick finish; reads as a planned architectural feature.
Corrugated Steel Well Moderate. Rusts and slowly bows over the decades. Usually a passive gravel pit. High flood risk in clay. Industrial and utilitarian.
Pre-Fab Plastic Kits Poor. Warps and cracks as marine clay expands against it. Pit clogs with silt; no active outlet, so water backs up. Reads as a plastic bucket bolted to the foundation.

4. The Northern VA Factor: Zoning, Utilities, and Code Compliance

Excavating six feet deep against a home on a tight lot in Arlington or Alexandria is where most of the risk lives. The trench for an egress well frequently lands on top of buried gas lines, sewer laterals, and electrical mains, so before any digging starts we file the Miss Utility (Virginia 811) locate and observe the required waiting period for the public lines to be marked. With 20+ years of hands-on experience on heavy structural sites, Tuck GC works the dig around those marked utilities and coordinates any rerouting needed to open a safe path for the well or walkout.

The opening itself has to satisfy specific egress parameters that Fairfax County and Prince William County inspectors will check. The window must provide a minimum net clear opening of 5.7 square feet — the actual hole an occupant fits through once the sash is open, not the rough-frame size. The bottom of that opening can sit no higher than 44 inches above the interior floor so it is reachable without a ladder, and the exterior well must give at least 9 square feet of floor area so a person can stand in it and climb out. We size the cut, the window, and the well to clear all three at once, build the header to the licensed PE's stamped drawing, and carry the project through permitting and the final county inspection so the room is legally recognized and added to the county tax records.

5. What Drives the Cost of an Egress Window in Arlington & Alexandria

An egress project is priced by how much structure and excavation the cut demands, not by the window alone. The real cost drivers are the depth of excavation (a deeper basement means a taller, more heavily reinforced well), the wall material being cut (10-inch poured concrete is harder and slower to saw than block), the structural header the licensed PE sizes to carry the load above the opening, the drainage solution your grade requires — a gravity line to daylight is simpler than a dedicated exterior sump pump — the well finish (stone or brick veneer over the CMU costs more than bare block), any utility conflicts with buried gas, sewer, or electric that have to be rerouted, and the permit and PE-stamped engineering every jurisdiction requires for a foundation cut. A full basement walkout, with its larger excavation and exterior staircase, sits well above a single window.

Because every egress is scoped to your foundation cut, stamped header, well finish, and drainage, we price each one individually rather than by a flat rate, and full walkouts are a larger structural undertaking. You'll find our project minimum and a full breakdown of what different budgets cover on our contact page.

See Our Full Pricing Breakdown

6. Egress Window FAQ

What drives the cost of an egress window or walkout?

Because we build a structural masonry well rather than dropping in a plastic kit, the price follows the structure the cut demands: the depth of excavation, whether you are cutting 10-inch poured concrete or block, the header the licensed PE sizes for the load, the drainage your grade needs, the well finish, and any buried utilities that have to be rerouted. A full basement walkout — with its larger excavation, retaining walls, and exterior staircase — is a much bigger undertaking than a single window. You'll find our project minimum and what different budgets cover on our contact page.

Will cutting the foundation weaken my house?

Not when it is done to a stamped design. The foundation wall carries the load of the floors and roof above it, so before the cut a licensed Virginia PE sizes a structural header — steel or engineered wood — to span the opening. We shore the floor above, make the cut, and set that header so the load bridges around the new void to the sound wall on either side. The opening is then a planned, engineered detail rather than a weak point.

Do I need a drain in the window well?

Yes — it is the part most often skipped and the part that fails. In Northern Virginia's clay, water cannot percolate out of a gravel pit, so without an active outlet the well fills during heavy rain, rises above the sill, and either floods the basement or loads the glass until it cracks. We build active drainage into every egress: a line to daylight, a tie-in to the interior foundation drain tile, or a dedicated sump pump, depending on your grade.

Do I need a permit and an engineer to cut a foundation for an egress window?

Yes. Cutting a structural opening in a foundation wall requires a local building permit and inspection from your county or city building department, and because the cut is load-bearing we coordinate a licensed Virginia Professional Engineer (PE) to produce PE-stamped drawings and calculations for the header. We then build the opening to the stamped design and carry it through the final county inspection so your new bedroom is legally recognized.

What makes a basement bedroom legal in Fairfax and Prince William County?

A basement room only counts as a legal bedroom when it has a code-compliant egress opening. Virginia code requires a minimum net clear opening of 5.7 square feet, a sill no higher than 44 inches above the interior floor, and an exterior well with at least 9 square feet of floor area. We size and build the egress system to meet those parameters so the room passes inspection and is added to the county tax records.

7. Unlock Your Basement's Potential

A code-compliant egress is what turns a finished basement into a legal, appraisable bedroom — and it is structural work that rewards doing it right the first time. From precision concrete cuts on tight Falls Church lots to multi-tiered stone walkouts for McLean estates, Tuck GC builds every opening to the licensed PE's stamped design, with a structural masonry well and active drainage instead of a plastic kit.

Egress work is one branch of our broader masonry & structural program. If the opening you need is above grade rather than below it, see our new door & window openings service, and for interior projects that open up a floor plan, review load-bearing wall removal. Whenever a cut carries structural load, we coordinate a licensed Virginia Professional Engineer (PE) for stamped drawings and build to that design. Contact us to plan your project.
